Tierra de Rosas
Recent Community Engagement
The Community Development Commission, along with Community Planning Collaborative and MidPen Housing, hosted community pop-up events on December 12, 2025. The pop-up events provided the community with project updates on Tierra de Rosas, and it provided the Community Development Commission an opportunity to hear the community’s voice on the future uses for the civic and commercial spaces at Tierra de Rosas. A community engagement survey was available December 1st through December 12th, 2025. In early 2026, shortly after the community pop-up events and survey results are available, a formal Request for Information (RFI) will be published for the civic and commercial spaces.
Background

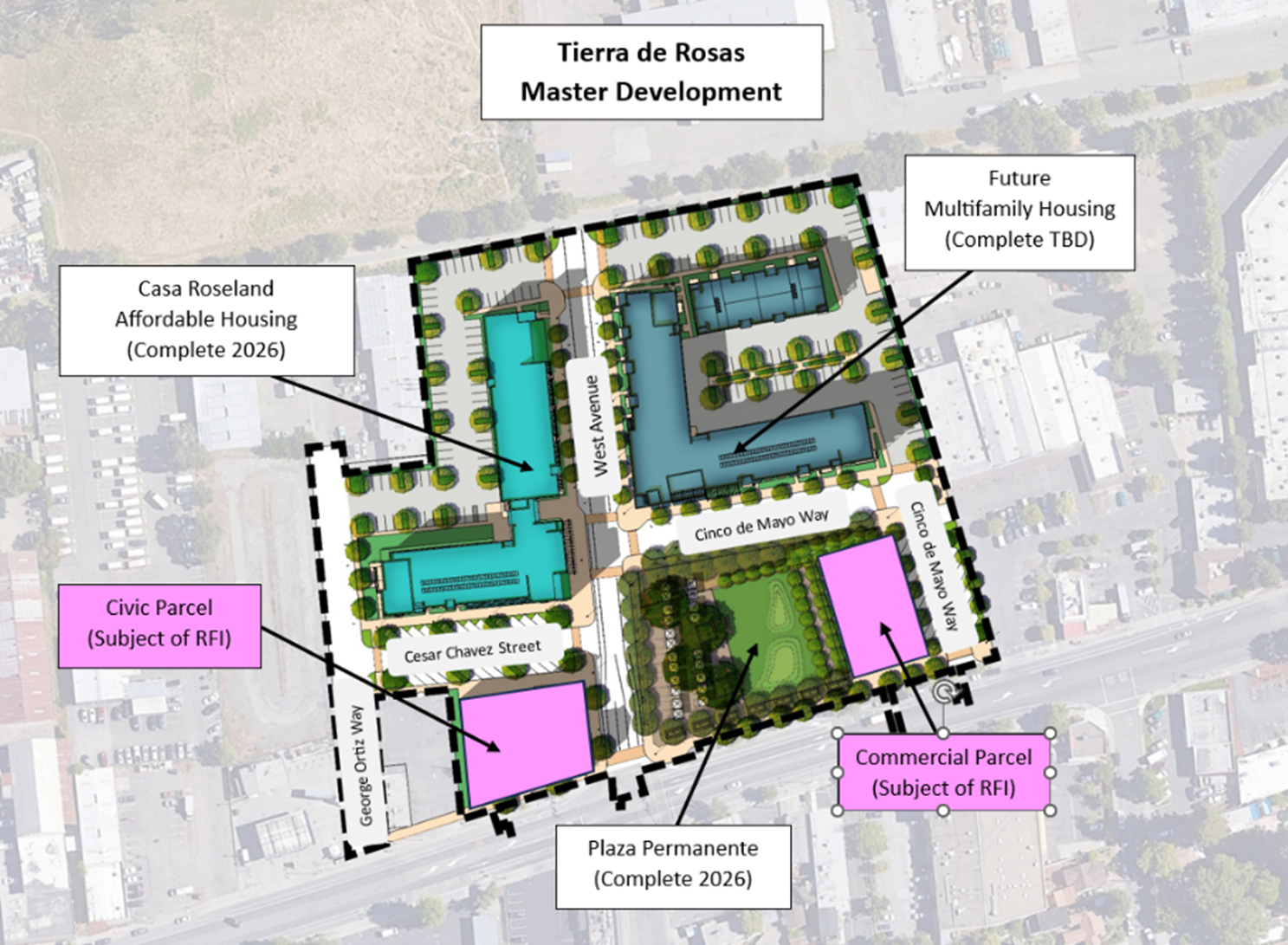

The Sonoma County Community Development Commission acquired the Roseland Village Shopping Center property in 2011 using local redevelopment funds. The goal was to develop a mixed-use project, one that would include affordable and market-rate housing, and public-serving areas and uses in the Roseland neighborhood of Santa Rosa. Tierra de Rosas refers to the infrastructure components of the project that will quite literally pave the way for the planned development of 75 affordable housing units, 100 market-rate units, a one-acre public plaza, a commercial space, and a civic space.
Following remarkable progress to expand funding sources and reduce costs, the Community Development Commission began construction in summer 2024 on Phase 1 of the backbone infrastructure for the Tierra de Rosas Mixed-Use Development. Phase 2 of the backbone infrastructure began in February 2025. Phase 3 of the project adds a one-acre public plaza, and started construction in fall 2025.
Tierra de Rosas infrastructure Phase 1 and 2 include site clearing, grading, excavation and backfill; installation of a detention basin for stormwater capture system; installation of wet utilities; joint trench dry utilities installation and relocation; surface improvements; and landscape amenities. As noted above, Phase 3 includes the public plaza, now known as the Plaza Permanente.
Project Schedule

- Construction contract executed: May 2024
- Commenced Phase 1infrastructure work: June 2024
- Completed Phase 1 backbone infrastructure: February 2025
- Commenced Phase 2 backbone infrastructure: February 2025
- Anticipated completion of Phase 2 backbone infrastructure: Early 2026
- Commenced Phase 3 public plaza construction: September 2025
- Anticipated completion Phase 3 public plaza: spring 2026
- Community engagement survey: December 1 through December 12, 2025
- Community engagement pop-ups for civic and commercial spaces: December 12, 2025
- Publication of Request for Information for civic and commercial spaces: January 2026
Project Footprint and Temporary Fencing During Construction

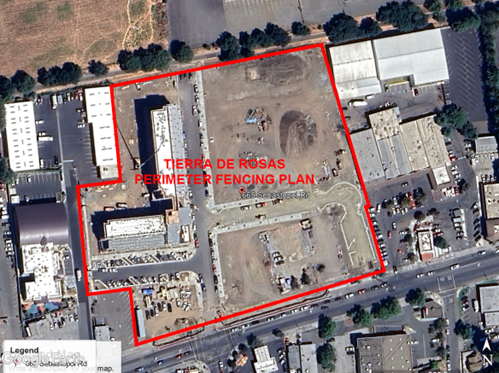

Construction activity will be confined to the outlined area on the map below, it approximates the location of temporary fencing to ensure public safety and security during construction.

Casa Roseland Groundbreaking
Text transcript for video of Casa Roseland groundbreaking »
Tierra De Rosas Groundbreaking Ceremony
Text transcript for video of groundbreaking ceremony at Tierra de Rosas (PDF) >>
Translate
